Mouscron - Zwevegem

The high-voltage line (70kV) between Mouscron and Zwevegem is going to be dismantled.

Mouscron-Zwevegem
  • texteBenefits to society
    The high-voltage line (70kV) between the Mouscron and Zwevegem high-voltage substations dates back to 1936, is outdated and will now be dismantled.
  • texteThe route

    The 70-kV high-voltage line between the Moeskroen and Zwevegem high-voltage substations will be dismantled over a distance of 9.5 kilometres.

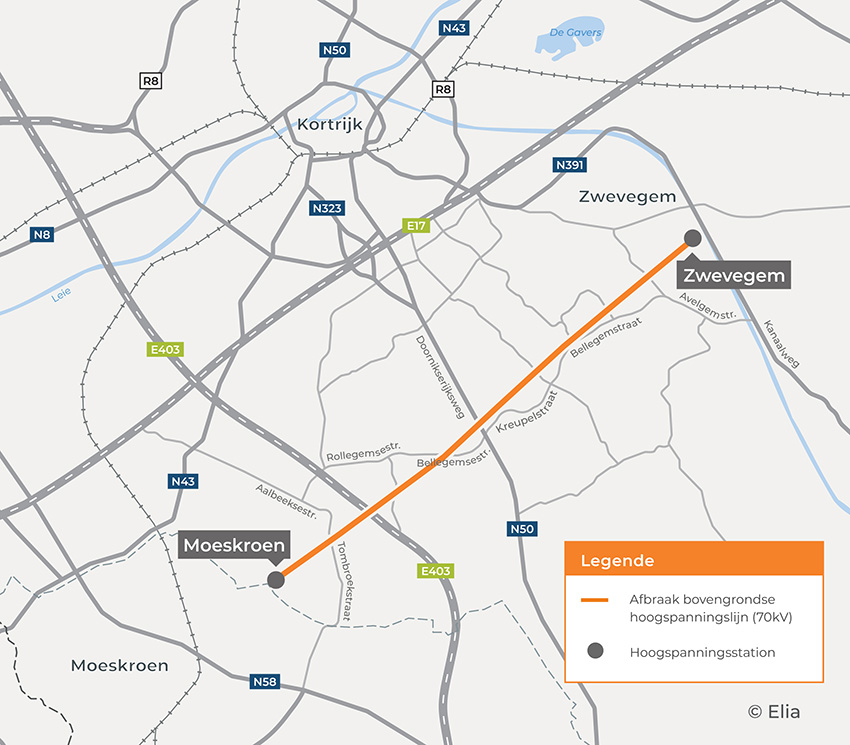

    Moeskroen - Zwevegem Basiskaart

  • environnementEnvironment

    Elia is always mindful of the local area when carrying out works. The high-voltage system operator takes a range of measures intended to mitigate disruption and impact on the local area.

    • The works will only take place during the day, between 7 a.m. and 7 p.m.
    • Once work is complete, the land is always restored to its original state.
    • Elia guarantees that homes and businesses will always be accessible during the works.
    • If local residents are set to experience a temporary increase in disruption for a specific reason, Elia or its subcontractor(s) will always individually notify those affected.
    • If normal traffic has to be diverted, the diversions will be agreed with the road authority and clearly communicated to local residents.

  • Schedule

    Elia will start to dismantle the high-voltage line on 8 April 2024; it will do this in a number of phases. The work will take one year to complete.

    The works will be carried out in a number of phases.

    1. Preparatory work will be done at the beginning of April 2024. For example, road plates and access roads will be laid to give machines easy access to the high-voltage pylons. Also, an Elia representative will visit all local residents with a high-voltage pylon on their private property before the works start.

    2. The overhead line will be de-energised.

    3. Next, protective wooden frames will be installed along the roadside.

    4. In a later phase, a roller will be used to remove the electricity cables.

    5. The pylons will then be removed with a tall crane. The final step will be for Elia to remove the foundations and carry out restoration work.

  • docInteractive map

    Click here to see the interactive map that shows the dismantling of the high-voltage line (70 kV).



  • docDocuments

    Information sheet - Dismantling of overhead line (in French and in Dutch)


News

20 December 2024

Demolition of overhead line between Moeskroen and Zwevegem almost finished

Demolition of the 70-kV overhead line between Moeskroen and Zwevegem has entered the final phase. This week, pylons near the Dottenijsestraat (Kortrijk) and the Kapel Milanendreef, Leeuwke and Avelgemstraat (Zwevegem) will be demolished. When work ends this week, all 58 pylons will have been demolished.

01 July 2024

E403 between Mouscron and Aalbeke closed on the night of 4-5 July

System operator Elia is currently dismantling the high-voltage line (70 kV) between Mouscron and Zwevegem. Because of this, the E403 between the Mouscron exit and the Aalbeke slip-road complex will be closed between 21.30 p.m. and 4 a.m. on the night of 4-5 July 2024.


Contact us

If you are affected by a project and want to ask us something, please feel free to contact us.
Our team would be happy to help.

This website uses cookies to provide you with an optimal browsing experience. Some cookies are strictly necessary for the operation of this website and cannot be rejected, while others are used for analytical/functional/targeting purposes and can be rejected. For more information, please consult ourCookie Policy . You can manage/change your cookie preferences at any time. If you do not manage your preferences, only the cookies which are strictly necessary will be accepted.
