Brugge Blauwe Toren-Waggelwater
Laying an underground electricity cable (150 kV) between the Brugge Blauwe Toren and Brugge Waggelwater high-voltage substations
Strengthening the high-voltage grid in and around Bruges
Elia is working on the high-voltage grid in and around Bruges to meet the increasing energy demand in the region. This includes laying a new underground 150-kV cable between the Brugge Blauwe Toren (Blankenbergse Steenweg) and Brugge Waggelwater (Waggelwaterstraat) high-voltage substations.
-
Benefits to societyThe transition to a carbon-neutral energy future is one of the most important challenges that our generation is facing. The ambitious climate objectives and geopolitical context have led Elia to accelerate the energy transition. One key to the success of the energy transition is the timely realisation of the grid infrastructure required, which will ensure the transmission of renewable electricity production and the interconnections with other North Sea countries, etc. So, Elia is working on the development of a robust and reliable high-voltage grid in Belgium.
In and around Bruges, electricity demand from households is increasing (due to an increase in heat pumps and electrical vehicles, etc.) and demand from companies for connection capacity is increasing too. This Elia project will ensure that industry in the region is able to continue to develop in the future. -

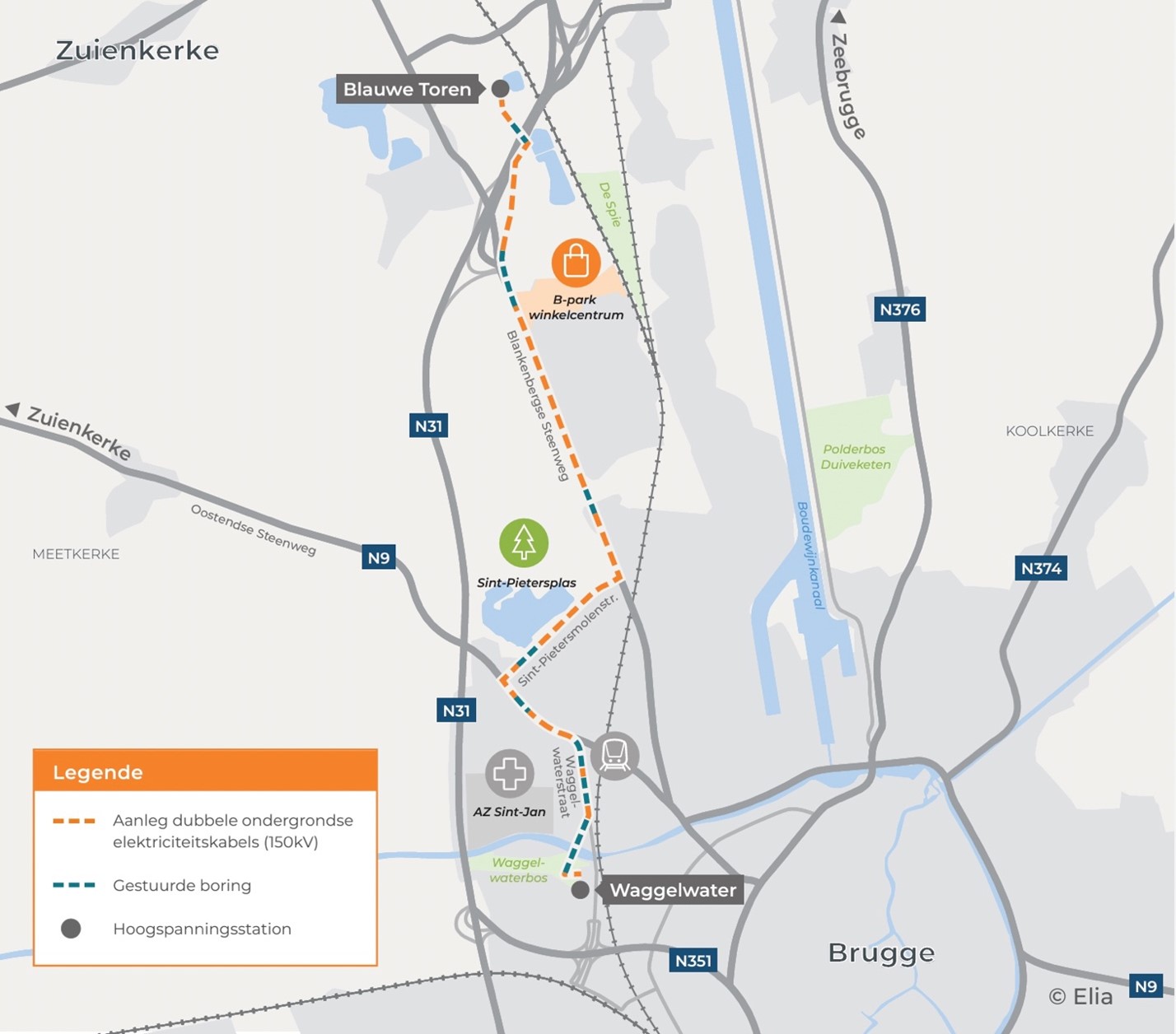

The route
Elia is laying a new underground high-voltage cable between two high-voltage substations: Brugge Blauwe Toren in the Blankenbergse Steenweg and Brugge Waggelwater in the Waggelwaterstraat. Elia is laying the cable via open trenches. Where possible, Elia will use directional drilling to keep disruption to a minimum.
-
Interactive map
-
Environment
Elia is always mindful of the local area when carrying out works. The high-voltage system operator takes a range of measures intended to mitigate disruption and impact on the local area.
- Work will only take place during the day, between 7 a.m. and 7 p.m.
- Elia guarantees that homes and businesses will always be accessible during the works.
- If local residents are set to experience a temporary increase in disruption for a specific reason, Elia or its subcontractor(s) will always individually notify those affected.
- If normal traffic has to be diverted, the diversions will be agreed with the road authority and clearly communicated to local residents.
- Once work is complete, the land is always restored to its original state.
-

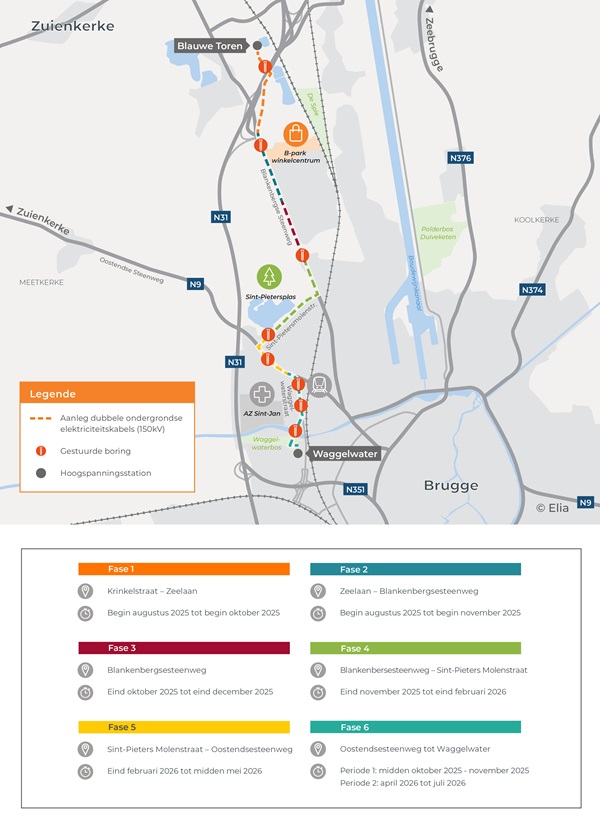

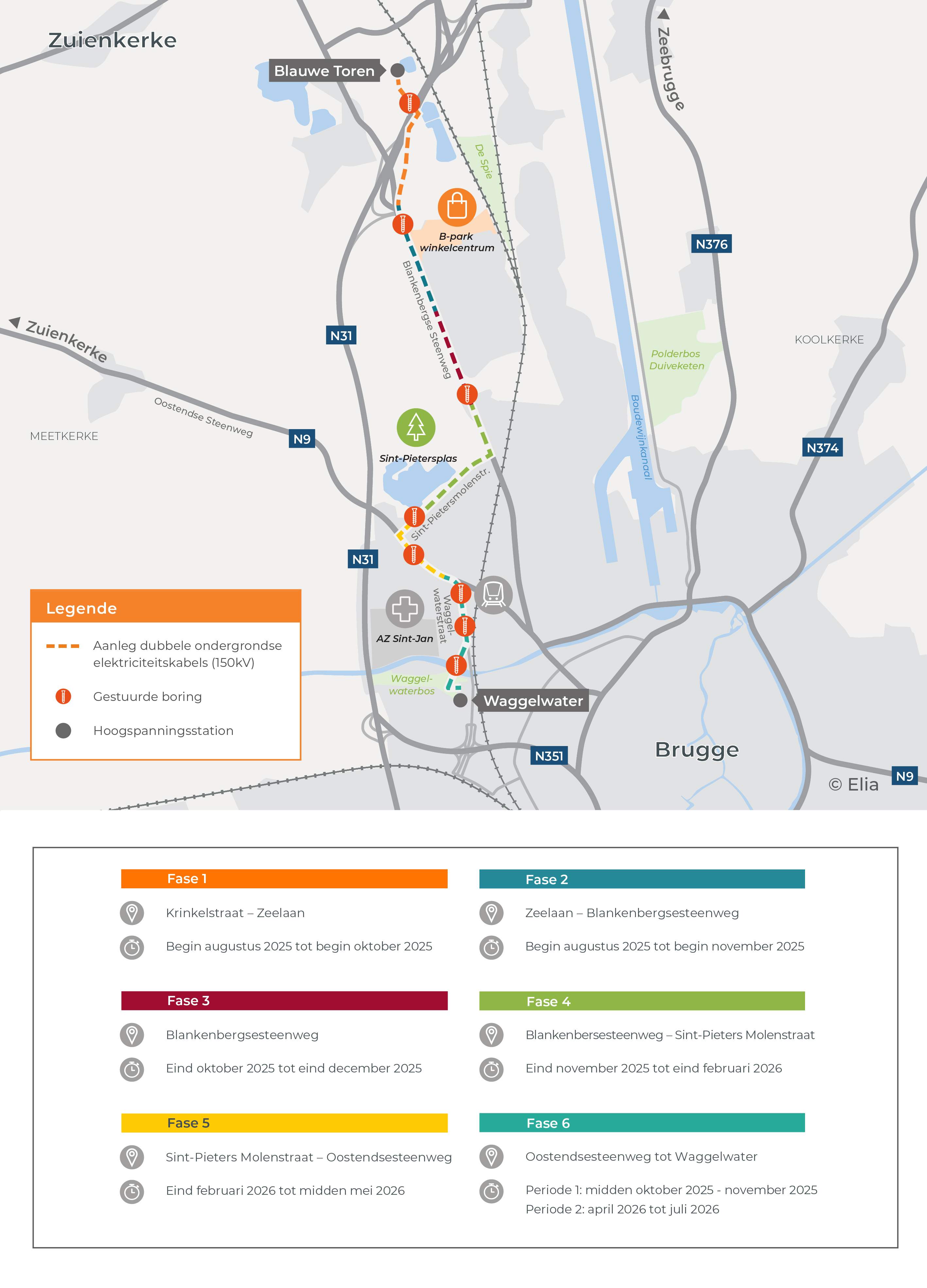

Schedule
- October 2024: submit application for environmental permit
- April 2025: start works
- February 2026: end works
-
Documents
News
Brugge Blauwe Toren-Waggelwater
10 December 2024
Underground high-voltage cable guarantees energy supply around Bruges
In the future, we will dismantle the existing overhead line between Brugge Blauwe Toren and Waggelwater, ready to build a stronger, new high-voltage line (380 kV) in the same location. However, a local 150-kV connection between Blauwe Toren and Waggelwater will continue to be crucial to guarantee the security of local energy supply. This is why we are planning to lay a 150-kV underground cable between Blauwe Toren and Waggelwater.
